On October 2, 2024 the HPC reviewed and approved a Substantial Amendment to revise the exterior façade of the building based on new information regarding historic material and overall integrity of the building from a historic preservation perspective.

On November 1, 2024 the change order reflecting the approval was submitted to the Building Department and it has been under review since.  Round 5 review comments were received from the Building Department October 12, 2026.  Round 5 response submission is planned for the week of November 2, 2026.

While the City continues to review the change order, they have allowed demolition, structural modifications and facade framing to proceed.  The site barricade was pulled back to within the site constraints and the traffic lane was re-opened in early July.

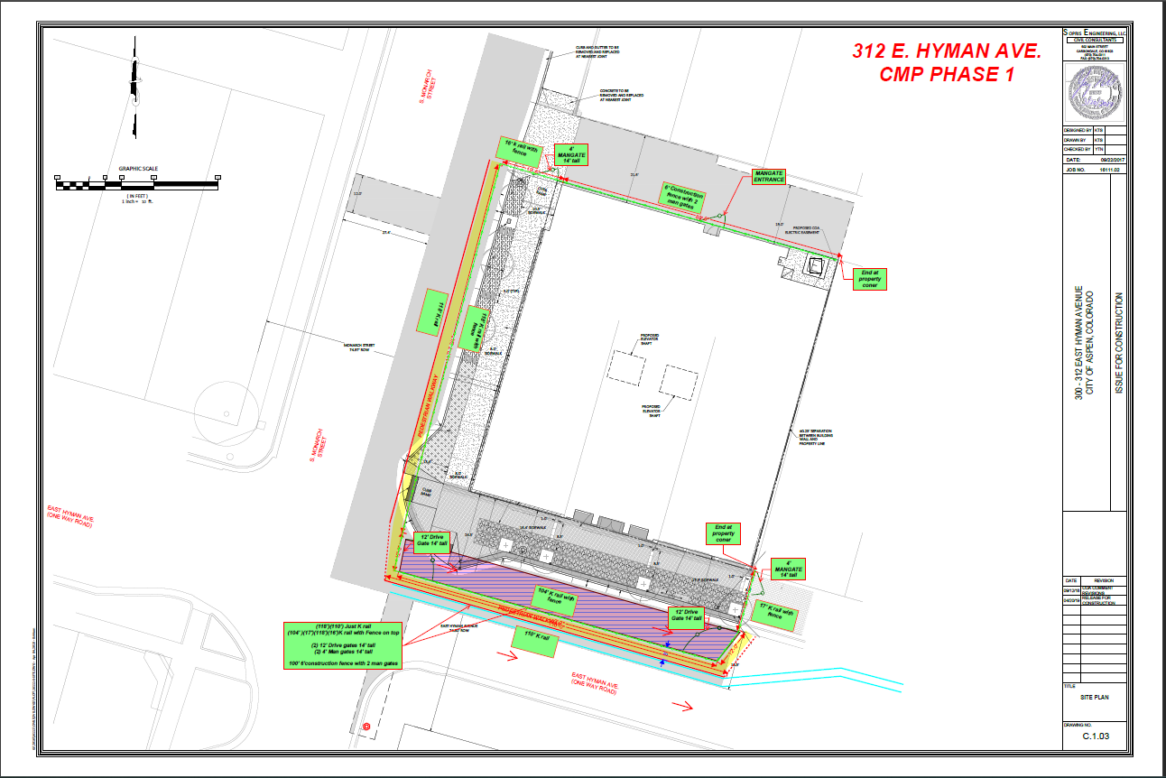

As of 10/5/26, the General Contractor re-mobilized and implemented the site barricade plan per the updated CMP.

Upcoming activities include:

  • Erection of CMP – Public impacts: sidewalk on Hyman and Monarch shut down while CMP is being moved out, sidewalk realignment after CMP set up.
  • Site office buildout – Public impacts: materials moving across the side walk on Hyman
  • CMU/Concrete demo – Public Impacts: Noise/dust from site starting at 8 am – Roughly 4:30 Monday-Friday, roll off’s being moved off site, brief road/sidewalk closures with traffic control while moving equipment in and out of the site.
  • Steel erection on Roof level – Public impacts: Noise from equipment and material handling starting at roughly 8am-4:30 Pm, Brief road and sidewalk closures with traffic control while equipment is moving on and off site.
  • Steel stud framing – Public impacts: noise from tooling/equipment starting at roughly 8am-4:30 pm, noise from cutting, grinding, installing, metal studs. Noise from equipment on site and material handling.
  • Concrete pour back – Public impacts: brief road and sidewalk closures with traffic control for concrete trucks and pumps moving on and off site
